Sensitivity and Risk: Stress-Testing the Business Case

One NPV hides its assumptions; a range shows them. Stress-test the office tower model with one-at-a-time sensitivity, a tornado diagram, scenarios and risk mitigations, then use a decision matrix to choose between projects.

Tan Kok XinTan Kok XinEnergy Management: The Economics of Saving Energy
Illustration of two people at a laptop beside a tornado chart, with a factory in the background

Part 9 of 10 in Cobler's Energy Management: The Economics of Saving Energy course. New here? See the course page.

When we plan a drive to a meeting, we rarely ask only "how long does it take?" We also ask "and if the traffic is bad?", because that answer decides when we leave.

A business case needs the same second question. Part 8 gave the tower's measure set an NPV of about RM956,500, and that number rests on assumptions.

How much demand does the BMS hold off? What do the AFA and tariffs do, what rate does finance use, and what does the work cost?

Asking those questions ourselves before an investment decision, and answering them with the model, is what we call sensitivity analysis.

If NPV, IRR and payback still feel unsteady, revisit Part 5 and Part 6 first. Here we change the inputs and watch those numbers move.

One number isn't enough

Imagine presenting "NPV = RM956,500" to the board and nothing else. Then the first sharp question comes: "And what if the demand limiting only holds off 60 kW, not 100?" Without a sensitivity analysis, we'd be guessing.

It has three layers, and each answers a different question:

  • One-at-a-time (OAT) sensitivity: which single input matters most?
  • Scenario analysis: what does a realistic bad case, or good case, look like when several inputs move together?
  • Risk and mitigation: what could go wrong, and what will we do about it?

As a reminder, here's the Part 8 base case for our example office tower, a made-up building on the MV non-domestic General tariff:

  • capex RM130,000 in Year 0
  • Year 1 savings of RM50,941 (energy, M1 and M2) and RM107,124 (demand, M3)
  • M&V and upkeep RM8,000 a year
  • electricity savings escalating 2% a year from Year 2, and upkeep 3%
  • 10 years at an 8% nominal discount rate

That gives a base NPV of about RM956,500.

One input at a time

OAT sensitivity holds everything fixed except one input. It moves that input to the low or high end of a range we can defend, and records how far NPV moves. We express the move as a percentage of the base NPV:

$$\text{Sensitivity} = \frac{\Delta \text{NPV}}{\text{NPV}_{\text{base}}} \times 100\%$$

Here \(\Delta \text{NPV}\) ("delta NPV") is the change in NPV, and \(\text{NPV}_{\text{base}}\) is the base-case NPV.

Let's start with the demand saving. Part 3 gave M3 a range of 60 to 120 kW, with 100 kW as the central estimate.

At 60 kW, the demand saving falls by 40 kW × RM89.27 × 12 = RM42,850 in Year 1. In the model that loss also grows 2% a year, like the saving it replaces.

Rerunning the Part 8 table with the lower figure lowers the NPV by about RM310,900.

A shortcut gives the same answer. At 8% with 2% growth over 10 years, each ringgit of Year 1 saving is worth about 7.256 ringgit today:

$$42{,}850 \times 7.256 \approx \text{RM}310{,}900$$

$$\frac{-310{,}900}{956{,}500} \times 100\% \approx -32.5\%$$

Now try the capex. A 30% cost overrun adds RM39,000. It happens once, in Year 0, so it isn't discounted:

$$\frac{-39{,}000}{956{,}500} \times 100\% \approx -4.1\%$$

So for this measure set, a shortfall in the demand saving moves the NPV about eight times as much as a big cost overrun. The build cost is small next to the savings, and the demand saving is the largest savings line.

The tornado diagram

So what about all the other inputs? We do the same for every important input, each across its own range, and list the results from the widest swing to the narrowest.

Drawn as horizontal bars with the widest at the top, this is what we call a tornado diagram, because of its shape.

The ranges should be ones we can defend, not a flat ±10% for everything. Here the savings ranges come from the low and high estimates in Part 3. The capex range is a ±30% overrun or saving, and the discount rate range is 5% to 12%.

Input and range tested

NPV at the low end

NPV at the high end

Swing as % of base

M3 demand held off (60 to 120 kW)

RM645,600

RM1,112,000

−32.5% / +16.3%

Discount rate (12% down to 5%)

RM779,800

RM1,125,900

−18.5% / +17.7%

M1 and M2 kWh savings (Part 3 low to high)

RM864,100

RM1,049,000

−9.7% / +9.7%

Electricity price rise from Year 2 (0% to 4% a year)

RM870,200

RM1,051,800

−9.0% / +10.0%

AFA for the whole period (0 to 7.34 sen/kWh)

RM916,100

RM997,000

−4.2% / +4.2%

Capex (30% over to 30% under)

RM917,500

RM995,500

−4.1% / +4.1%

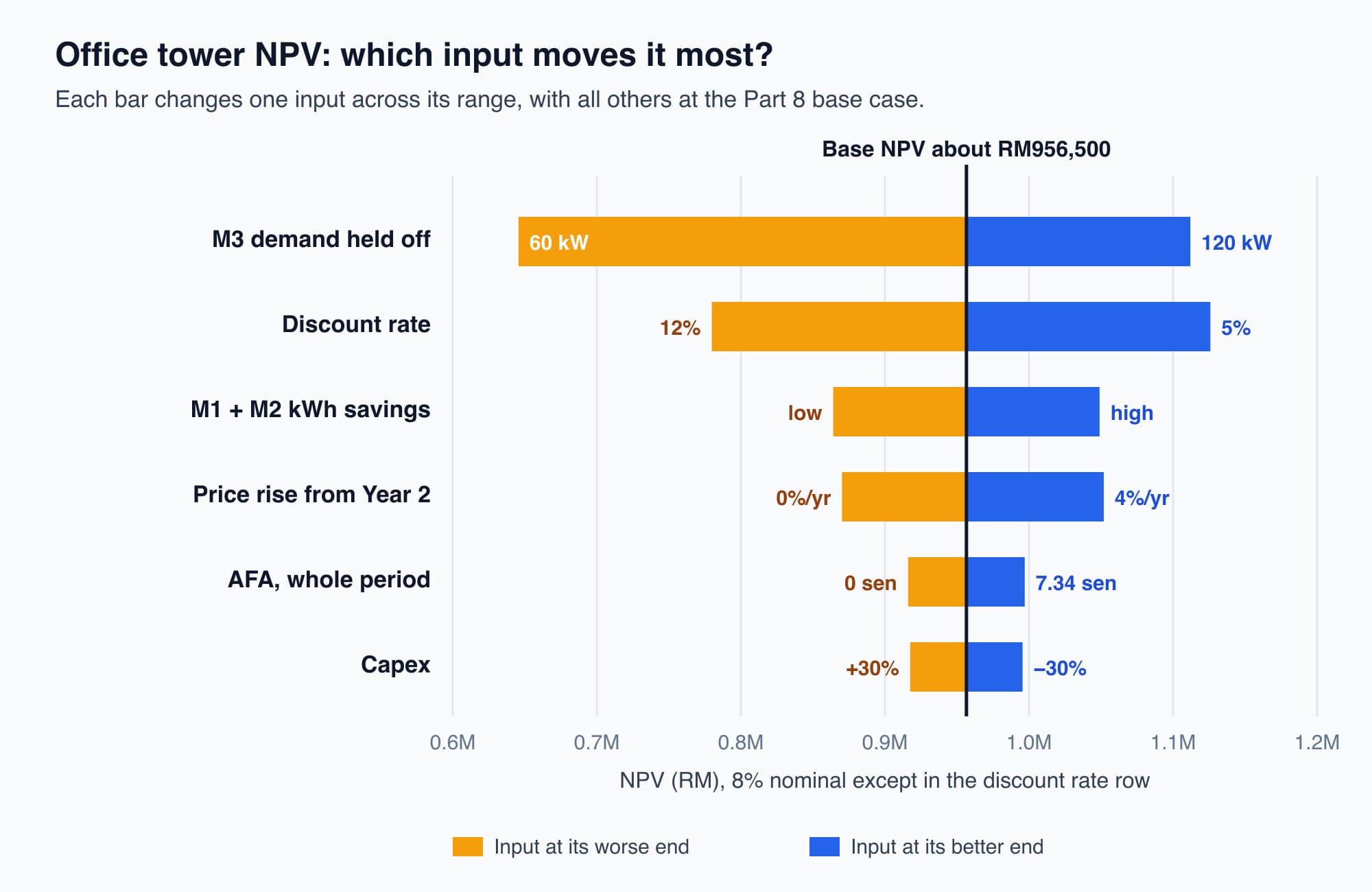

Tornado diagram of the office tower NPV, with horizontal bars for six inputs around the base NPV of about RM956,500, widest for the M3 demand saving and narrowest for capex

The tornado for the office tower measure set: the demand saving and the discount rate move the NPV most, and capex moves it least.

Three points about the ranges:

  • The AFA row. Part 2 used the September 2026 AFA (+3.67 sen/kWh) for every month, which is an assumption, because the AFA changes monthly. The row tests an average AFA anywhere from zero to twice September's figure. It changes only the energy saving, because the AFA is charged per kWh.
  • The electricity price row. Year 1 (2027) is inside the RP4 tariff period, so only Years 2 to 10 change.
  • No row for carbon. An internal carbon price isn't cash, so it isn't in the NPV and has no bar. Report the carbon value separately.

So the tornado tells us where to spend our effort. For this measure set, the most useful work is to prove that the demand limiting lowers the monthly peak.

The next is to agree the discount rate with finance early. Tightening the capex quote by a few thousand ringgit barely changes the answer.

A project that saves only kWh, such as lighting, would have a different tornado, with the tariff and hours near the top. So draw it fresh for each project.

Worth knowing: if you want to test the demand side yourself, our maximum-demand calculator shows how a lower peak changes the monthly charge.

If M3 fails

The tornado raises a sharper question. What if M3 delivers nothing at all, for example because tenants override the sequence on hot afternoons?

So let's set the demand saving to zero, keep the RM35,000 spent on M3 in the capex, and rerun the model:

  • NPV falls from about RM956,500 to about RM179,200.
  • Simple payback stretches from about 10 months to about 3.0 years (RM130,000 ÷ (RM50,941 − RM8,000)).

So the project still makes money, but most of its value has gone. That's useful to know before we sign.

It tells us the demand saving deserves the closest M&V attention. That's why the Part 4 plan checks each month's MD against the BMS log of the kW held off.

Scenarios

But OAT moves one input at a time, and a real bad year often brings several problems at once. Scenario analysis groups a consistent set of assumptions into named cases, usually three:

  • Low case: NPV about RM458,300. All three measures sit at their Part 3 low estimates (RM102,480 a year of savings), and capex runs 30% over budget (RM169,000). There's no electricity price rise after Year 1, and the simple payback is about 1.8 years.
  • Medium case: NPV about RM956,500. This is the Part 8 base case, the one we plan around.
  • High case: NPV about RM1,204,400. All three measures sit at their high estimates (RM192,226 a year), capex stays on budget, and prices rise 2% a year.

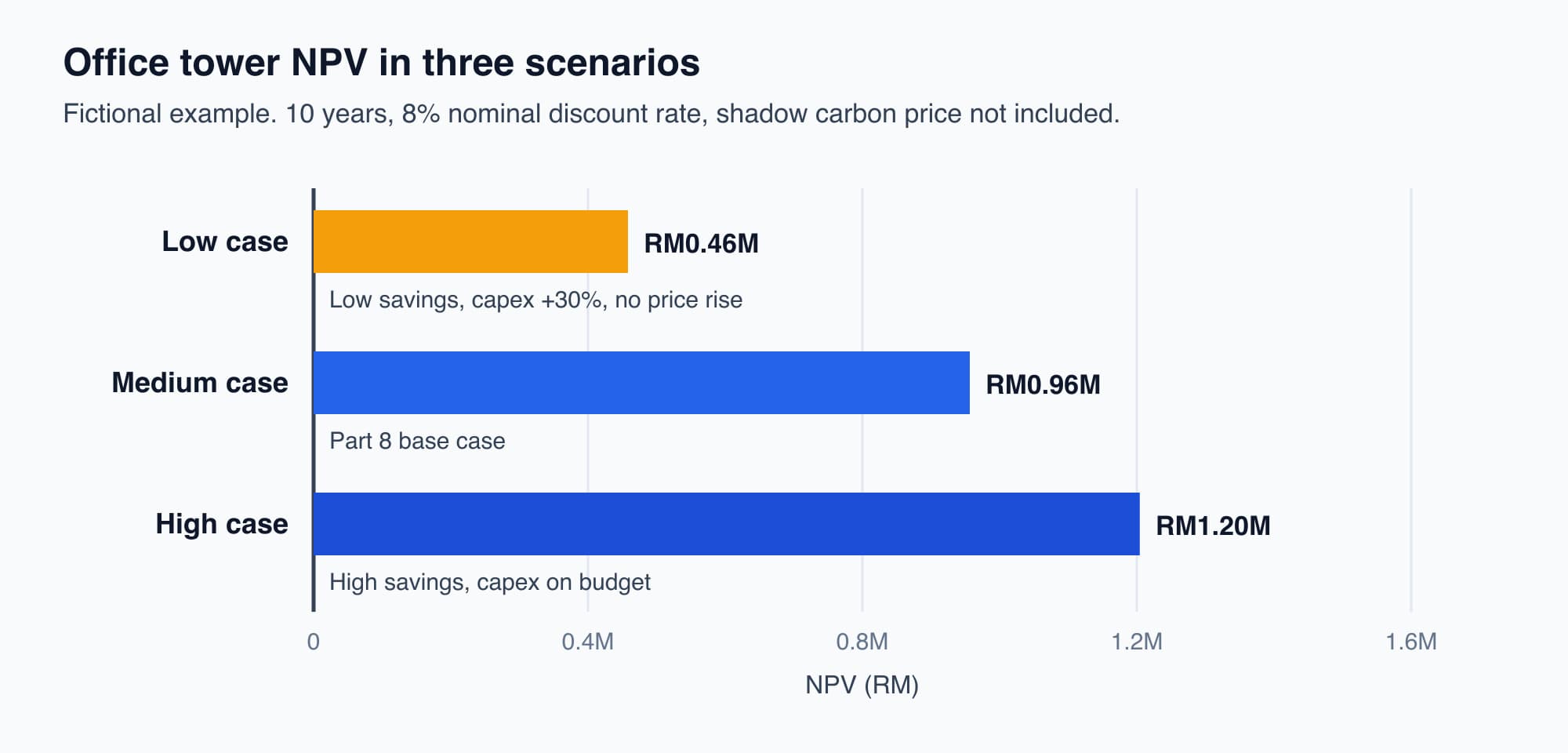

Three horizontal bars showing the office tower NPV in the low, medium and high cases, about RM0.46 million, RM0.96 million and RM1.20 million, all above zero

Even the low case stays well above zero, so the measure set makes money across the whole plausible range.

So we can give the board a stronger message than one figure. "Across a plausible range from about RM0.46 million to RM1.20 million, this measure set does not lose money."

If the low case had gone negative, that would also be useful to know. It would tell us the project works only if things go well, and we'd tighten the weakest assumption before committing.

Risks and mitigations

Sensitivity tells us how much an input matters. Risk management decides what we'll do about it, so we pair every material risk with a concrete action:

  • The demand limiting doesn't hold the peak (M3). Test the sequence through a hot month before handover (this is already in the M3 capex). Then check each month's MD against the BMS log, as the Part 4 plan requires.
  • Tariff and AFA changes. Show the AFA and price-rise rows from the tornado in the business case, so nobody is surprised when the monthly AFA moves.
  • Capex overrun. Build a 10 to 15% contingency into the budget from the start, rather than finding the overrun later as a variance.
  • Savings fade over time. Apply a degradation factor, assuming savings fall 1 to 2% a year as schedules drift and equipment ages. At 2% a year, the office tower NPV falls from about RM956,500 to about RM868,600.

Each mitigation changes the model a little. The contingency raises capex, and the degradation factor trims savings.

Applied honestly, they move the medium case slightly towards the low case. And a business case that still works after its own mitigations is one we can defend.

The stress tests are also easier when the savings assumptions come from measured data rather than a one-off spreadsheet. Interval readings from the building's meters let us replace a guessed degradation factor with a measured one.

They also let us check each month whether the top bar of the tornado is holding up. We cover those readings in how electricity meters work.

Choosing between projects

So far we've tested one project. But there's a different problem when we have three good projects, all with positive NPV, and budget for only one.

NPV alone may not decide it, because the projects are strong in different ways. So we need to weigh several criteria at once, with a multi-criteria decision matrix.

The method has three steps:

  1. Normalise each measure onto a common 1 to 10 scale (10 = best). Then a payback in years and an NPV in ringgit can be compared.
  2. Weight each criterion by how much it matters to your organisation. One reasonable default is NPV 30%, IRR 20%, Payback 20%, Carbon 20%, Risk 10%.
  3. Score each project as the weighted sum, then rank them.

The weighted score is:

$$S = \sum_{i} w_i \times s_i$$

Here \(w_i\) is a criterion's weight and \(s_i\) is the project's normalised 1 to 10 score on it.

Let's try it on a separate example, three candidates on a Malaysian factory site:

  • Project A: LED lighting retrofit (a balanced all-rounder)
  • Project B: high-efficiency chiller replacement (large, big carbon saving, slow payback, higher risk)
  • Project C: compressed-air and steam leak-repair programme (cheap, fast payback)

Criterion (weight)

Project A

Project B

Project C

NPV (30%)

6.5

8.0

7.2

IRR (20%)

7.0

4.0

9.5

Payback (20%)

7.5

3.0

9.5

Carbon (20%)

6.0

9.5

5.0

Risk, higher = safer (10%)

7.3

2.3

7.0

Weighted score

6.78

5.93

7.66

Project C's total shows the arithmetic:

$$S_C = (0.30 \times 7.2) + (0.20 \times 9.5) + (0.20 \times 9.5) + (0.20 \times 5.0) + (0.10 \times 7.0) = 7.66$$

So Project C wins at 7.66, ahead of A (6.78) and B (5.93). The leak repair isn't the largest project, and the chiller has a larger NPV and a much larger carbon saving.

But C's high IRR, very short payback and low risk give it the highest weighted score.

It also helps to score ease of implementation from 1 to 10 alongside risk, because a project we can deliver beats one that stalls. For example:

  • leak repair 9 (a few valves and a weekend)
  • LED retrofit 8 (swap fittings, little disruption)
  • chiller replacement 2 (major plant, downtime, long procurement)

The easy, cheap measures are usually the ones to do first.

Worth knowing: the optional side reading on the abatement cost curve shows the same thing from the carbon side.

The winner changes with the weights

But the ranking reflects our priorities, and it isn't a fixed fact about the projects. Let's rerun the same table for a firm with a hard carbon target, weighted NPV 20%, IRR 10%, Payback 10%, Carbon 50%, Risk 10%:

  • Project B: 7.28
  • Project C: 6.54
  • Project A: 6.48

Now Project B, the chiller, wins. Nothing about the projects changed, only what the firm decided to value.

A business short of cash would reasonably pick C, and a business focused on cutting carbon would reasonably pick B. The method makes us state our priorities as numbers before the answer appears.

So run the matrix at two or three sets of weights and show the board how the winner moves. If your preferred project wins under only one convenient set of weights, that's worth knowing.

Try it

Loading the interactive

Making the case

So now we have the tower's cash-flow model and a clear view of how far its answer can move. The case holds across the whole range, and we know the one input to watch.

That takes us back to the question from Part 1. Are the tower's three ideas worth the money? And how do we put that on one page for management, with the plan that will prove it?

We'll do it in Part 10, Making the Case: A Full Energy Project Appraisal, Start to Finish.

Check your understanding

1. In the office tower case, a 30% capex overrun changes the NPV by only about 4%. Why does M3 at 60 kW instead of 100 kW change it by about a third?

Show the answer

The overrun is RM39,000, paid once in Year 0. The demand shortfall is RM42,850 in Year 1 and grows every year for ten years, so its present value is about RM310,900. A loss that repeats every year outweighs a one-off cost of a similar size.

2. Why is there no bar for the internal carbon price in the tornado?

Show the answer

Because the internal carbon price isn't cash, so it isn't part of the NPV. Changing it wouldn't move the NPV at all. The carbon value is reported on a separate line.

Recap

  • One NPV hides how fragile it is, and a range shows it.
  • One-at-a-time sensitivity finds the inputs that move the NPV most, and a tornado diagram ranks them.
  • For the office tower measure set, the M3 demand saving and the discount rate matter most, and capex least.
  • Even if M3 delivers nothing, the NPV stays positive at about RM179,200.
  • Scenarios show a plausible range of about RM0.46 million to RM1.20 million.
  • Each risk gets a mitigation, and a weighted decision matrix helps us choose between projects while showing how the winner depends on our priorities.

This is Part 9 of 10 in Cobler's Energy Management: The Economics of Saving Energy course. Previous: Building an Energy Project Cash-Flow Model. Next: Making the Case: A Full Energy Project Appraisal, Start to Finish.
