Making the Case: A Full Energy Project Appraisal, Start to Finish

A full energy efficiency business case for one office tower measure set: savings at the marginal rate, life-cycle cost, NPV, payback, IRR, sensitivity, cost per tonne and the M&V plan, on one page.

Tan Kok XinTan Kok XinEnergy Management: The Economics of Saving Energy
Illustration of an engineer and a manager reviewing a plan above a large plant vessel with pipes and a gauge

Part 10 of 10 in Cobler's Energy Management: The Economics of Saving Energy course. New here? See the course page.

Back in Part 1, the electricity bill arrived and someone had an idea to make it smaller. We asked whether an idea like that is worth the money, and what it does for carbon.

And we promised to take the office tower's three ideas all the way to a one-page energy efficiency business case for management. So now let's write it.

If you've ever asked your family, or a bank, to agree to a big spend, you know what they'll ask. What does it cost, what does it save, how sure are you, and how will we know it worked? A business case answers the same four questions for a finance director.

Part 9 showed how far the tower's NPV can move and which assumption matters most, so the case is ready.

We'll run the tower's measures through every tool in the course, from start to finish. Each step reuses a number we've already calculated, so we can see how the parts fit together.

The project on the table

Our example office tower is a made-up 20-storey office building in Kuala Lumpur, supplied at 11 kV on the MV non-domestic General tariff. It uses about 6,000,000 kWh a year, and its maximum demand (MD) is about 1,600 kW. The facility team proposes three measures:

  • M1, chiller plant scheduling. Stop the chiller plant at 6pm with the air handling units, instead of running it on an old schedule until 8pm. An after-hours request button covers late tenants. RM15,000.
  • M2, variable speed drives (VSDs) on the two condenser water pumps. Let the pumps slow down when full flow isn't needed. RM80,000.
  • M3, BMS demand limiting. In the highest half-hours, the building management system (BMS) holds off car park fans, water transfer pumps and a small chilled-water temperature reset. So the monthly peak falls. RM35,000.

The total capital cost (capex) is RM130,000, installed from October to December 2026. The first full year of savings is 2027.

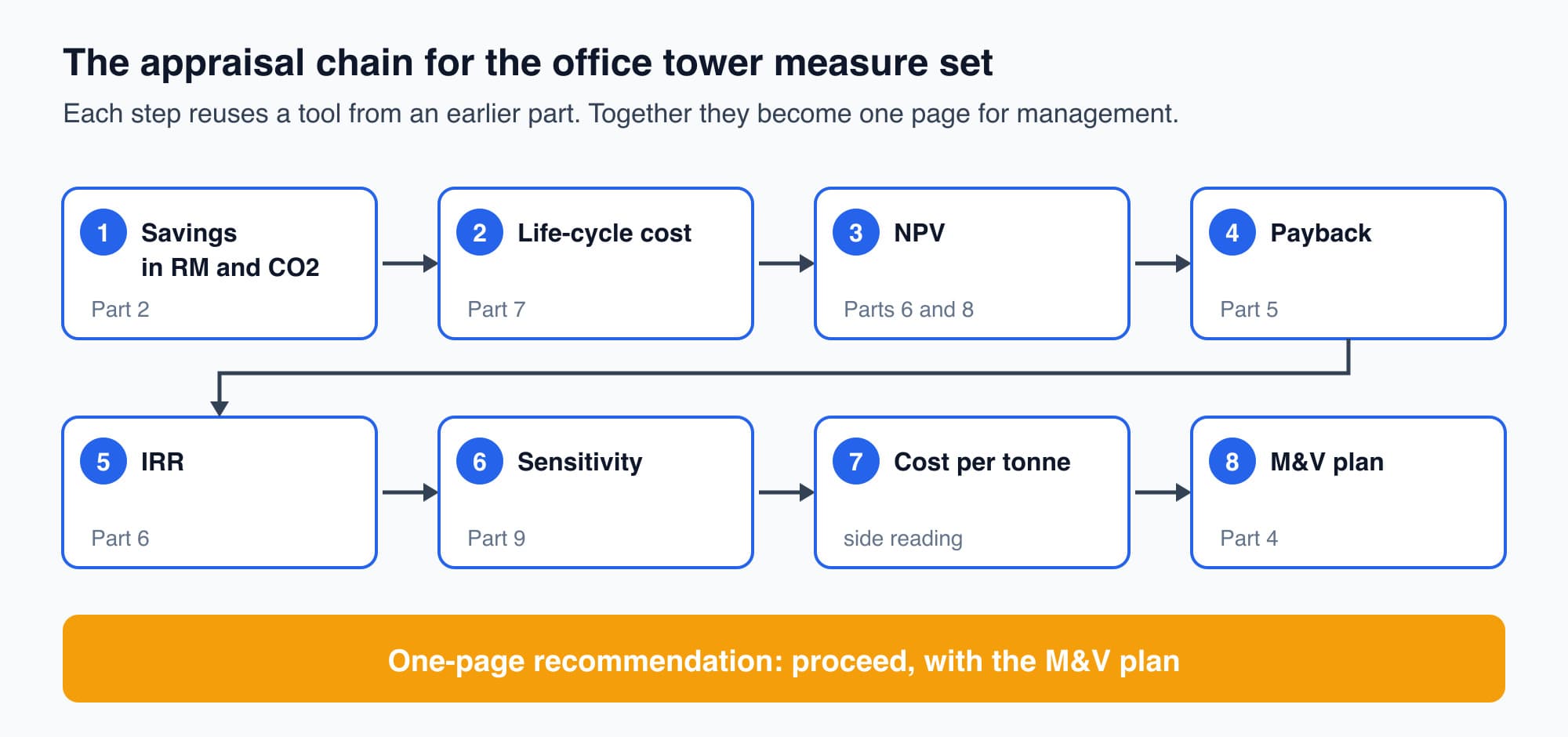

Flow of eight boxes from savings in ringgit and carbon, through life-cycle cost, NPV, payback, IRR, sensitivity and abatement cost, to the M&V plan and the one-page recommendation

The appraisal chain: each step uses a tool from an earlier part of the course, and together they become one page for management.

Savings in ringgit and CO2

So first, what does it save? Part 2 valued each measure at the marginal rate, the price of the last kWh rather than the average of the whole bill.

For this tariff that's the energy charge plus the Automatic Fuel Adjustment (AFA), 29.83 + 3.67 = 33.50 sen/kWh. We use the September 2026 AFA for every month.

A demand saving counts only if the monthly peak really falls, at RM89.27 per kW each month, and the retail charge never falls.

Measure

kWh saved a year

Ringgit a year (2027)

CO2e a year

M1 chiller scheduling

105,600

RM35,376

78.1 t

M2 condenser pump VSDs

46,464

RM15,565

34.4 t

M3 demand limiting (100 kW off the MD)

0

RM107,124

0

Total

152,064

RM158,065

112.5 t

Three details make these numbers believable:

  • Overlapping measures aren't simply added. M2 is counted only over the 11 core hours a day that remain after M1 has cut the plant's evening hours. On the old schedule one pump also ran from 6pm to 8pm. Counting those hours for M2 too would have claimed 4,224 kWh a year that M1 already removes. So when measures act on the same equipment or the same hours, value the second one after the first.
  • M3 moves load rather than removing it, so it saves no kWh and claims no carbon. Its value is entirely the lower MD charge.
  • Carbon uses the Peninsular grid emission factor of 0.740 kg CO2e per kWh (2024, provisional, Suruhanjaya Tenaga): 152,064 × 0.740 ≈ 112.5 tonnes a year.

All ringgit figures are before the KWTBB (Renewable Energy Fund) levy and tax. The kWh saving is about 2.5% of the building's annual use, which matters later for how we prove the saving.

Life-cycle cost and NPV

Next, is it worth more than it costs? Part 7 showed that life-cycle cost (LCC) compares two futures over the same period in today's money.

Here the period is 10 years, and the discount rate is 8% nominal, an illustrative rate used with nominal cash flows. We assume electricity prices rise 2% a year after the current RP4 tariff period ends in December 2027.

  • Do nothing. The tower keeps paying about RM3,726,384 a year (twelve September-sized bills of RM310,532), rising 2% a year from Year 2. In today's money, ten years of that is about RM27,039,000.
  • Do the measures. We spend RM130,000 now, pay the same bills minus the savings, and add RM8,000 a year (rising 3% a year) for M&V and upkeep. In today's money that's about RM26,083,000.

So doing nothing isn't free. The gap between the two life-cycle costs is the NPV:

$$NPV = LCC_{\text{baseline}} - LCC_{\text{proposed}}$$

RM27,039,000 − RM26,083,000 ≈ RM956,000 (the unrounded figures give RM956,547). The measure set changes the tower's ten-year electricity cost by only about 3.5%. But in ringgit that's a large sum for a RM130,000 outlay.

We can also reach the same NPV straight from the savings, as in Part 8. The savings grow 2% a year, so we value them as a growing stream.

In the formula, \(C\) is the Year 1 amount and \(r\) is the discount rate. Then \(g\) is the yearly growth and \(n\) is the number of years:

$$\text{PV}_{\text{savings}} = \frac{C}{r-g}\left[1-\left(\frac{1+g}{1+r}\right)^{n}\right] = \frac{158{,}065}{0.08-0.02}\left[1-\left(\frac{1.02}{1.08}\right)^{10}\right] \approx \text{RM}1{,}146{,}900$$

The same formula for the RM8,000 a year of upkeep, growing 3% a year, gives about RM60,400. Then:

$$\text{NPV} = \underset{\text{PV of savings}}{\underbrace{1{,}146{,}900}} - \underset{\text{PV of upkeep}}{\underbrace{60{,}400}} - \underset{\text{Capex}}{\underbrace{130{,}000}} \approx \text{RM}956{,}500$$

This matches the year-by-year table in Part 8. The NPV is strongly positive. After paying for the work and its upkeep, the owner is about RM956,500 better off in today's money than by doing nothing.

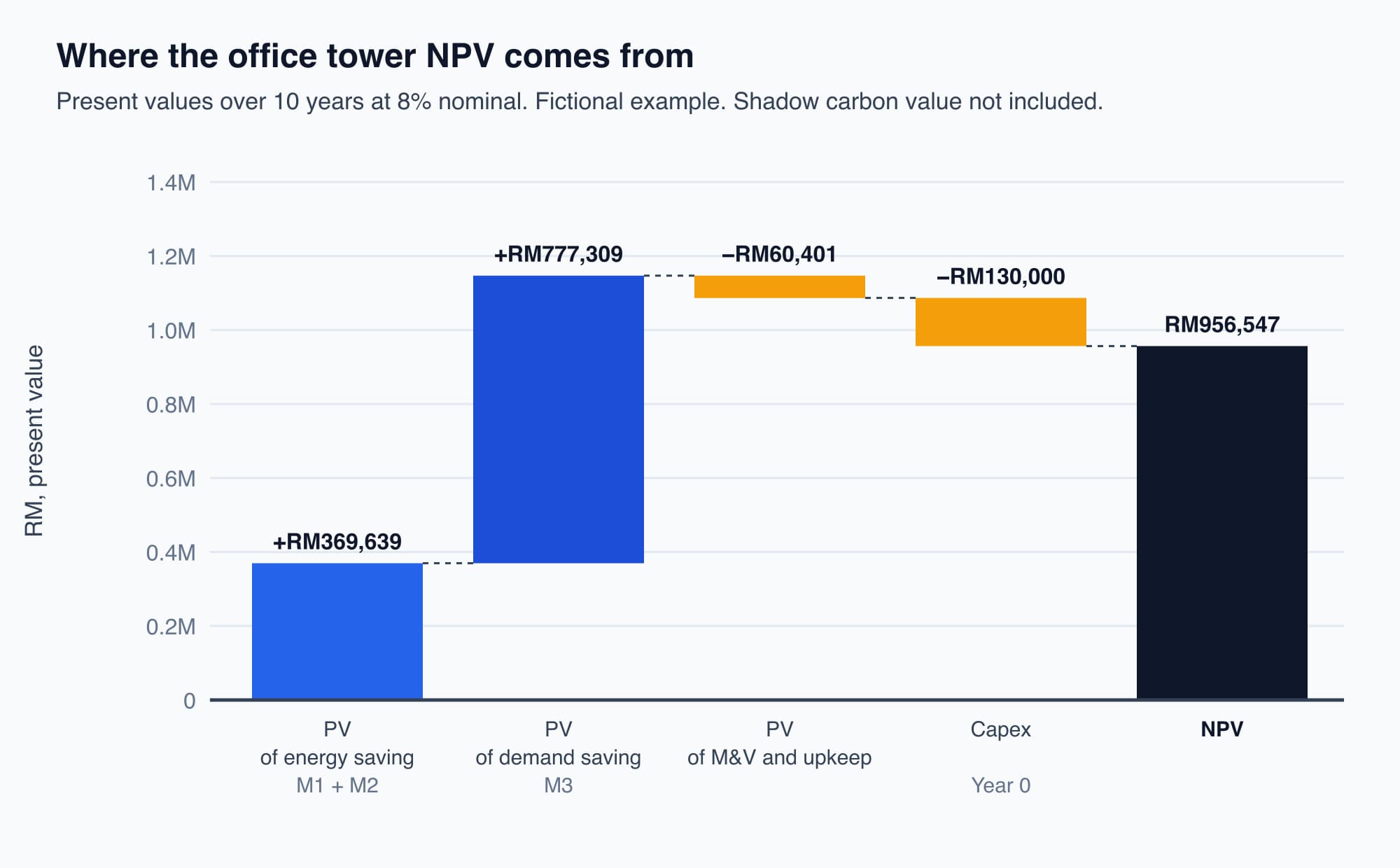

Waterfall chart building the office tower NPV from the present value of energy savings and demand savings, minus upkeep and capex, ending at about RM956,500

Where the NPV comes from: the demand saving from M3 is the largest single block, so the rest of the case checks it most carefully.

We keep the carbon value separate. Say your company uses an internal carbon price of an illustrative RM50 per tonne. Then the tower's 112.5 tonnes a year are worth about RM5,630 a year, or about RM37,800 over ten years in today's money.

But that's a policy value, not cash, so it's not added to the NPV, payback or IRR. Show it on its own line.

Payback and IRR

So how fast does the money come back? Simple payback divides the capex by the yearly net saving and ignores the time value of money. It's rough, but everyone understands it:

$$\text{Simple payback} = \frac{\text{Capex}}{\text{Annual net saving}} = \frac{130{,}000}{150{,}065} \approx 0.87\ \text{years}$$

The Year 1 net saving is RM158,065 − RM8,000 = RM150,065. So the money comes back in about 10 months, if the savings arrive evenly through the year.

Using the discounted Year 1 figure (RM138,949), the discounted payback is about 0.94 years, about 11 months.

Controls measures such as scheduling and demand limiting often pay back quickly, because they change how existing equipment runs rather than replacing it. A chiller replacement would take far longer.

And how hard is the money working? The internal rate of return (IRR) is the discount rate at which the NPV equals zero, the project's own built-in return.

We compare it with the hurdle rate, the minimum return the company requires, here our 8%. Formally IRR solves:

$$0 = -\text{Capex} + \sum_{t=1}^{n}\frac{\text{Benefit}_t}{(1+\text{IRR})^t}$$

Here the benefit in each year is the net cash from the Part 8 table. Solving it by trial and error, as in Part 6, gives an IRR of about 117%. When the IRR is this far above the hurdle, small errors in it don't change the decision.

What could break it

So how sure are we? Part 9 changed each input across a range and showed the results in a tornado diagram. The findings for management are:

  • The M3 demand saving is the largest risk. If the BMS holds off 60 kW instead of 100 kW, the NPV falls to about RM645,600. If M3 delivers nothing at all, the NPV is still about RM179,200 and the payback is about 3 years.
  • The discount rate comes second. Between 12% and 5%, the NPV ranges from about RM779,800 to RM1,125,900.
  • Capex matters least. A 30% overrun (RM39,000) lowers the NPV by only about 4%.
  • Scenarios. The low case (low savings, 30% overrun, no price rise) gives about RM458,300, and the high case about RM1,204,400. The measure set doesn't lose money anywhere in that range.

So here's the honest headline for management: the result depends mainly on whether the demand limiting lowers the monthly peak, not on the construction cost.

Cost per tonne

There's one more number the carbon side will want, the cost of each tonne avoided. The optional side reading on the abatement cost curve ranks carbon measures by that cost.

To estimate it, we use Year 1 figures in four steps:

  1. Spread the capex over 10 years with the capital recovery factor (CRF) from Part 7. At 8% over 10 years, that's 0.1490.
  2. Add the yearly upkeep.
  3. Subtract the yearly saving.
  4. Divide by the tonnes.

$$\text{Cost of abatement} = \frac{(130{,}000 \times 0.1490) + 8{,}000 - 158{,}065}{112.5} \approx -\text{RM}1{,}160/\text{tCO}_2$$

A negative cost means the measures save money while cutting carbon. On an abatement cost curve they sit at the far left, among the measures to do first.

Worth knowing: this is a simplified estimate, which uses Year 1 savings and ignores escalation. It also spreads the whole package's saving over the tonnes from M1 and M2, since M3 saves money but no tonnes.

This takes us back to the net zero balance from Part 1. Malaysia has committed to net zero by 2050, and a widely used rule in net-zero planning is reduce first, offset last.

Buying carbon credits for the same 112.5 tonnes would cost money every year, about RM5,630 a year at an illustrative RM50 per tonne. The measures instead save about RM150,065 a year, net of upkeep, while avoiding those tonnes.

So credits are for the emissions we can't remove by running the building better.

Proving the savings

Every figure so far is a forecast, though. The business case is only proven once measured savings confirm it, so the memo must say how that will happen.

In Part 4 we wrote the measurement and verification (M&V) plan for this measure set:

  • Periods. Baseline October 2025 to September 2026, installation October to December 2026, and reporting period January to December 2027.
  • M1 evidence. The chiller plant sub-meter. Plant kWh from 6pm to 8pm on weekdays should be near zero, except for after-hours requests, which the BMS logs.
  • M2 evidence. New meters on the two condenser pump feeders. The adjusted baseline is 54.0 kW × the actual run hours, and the saving is that baseline minus the metered kWh.
  • M3 evidence. Each month's MD from the TNB bill, cross-checked against the BMS log of the kW held off in that month's highest half-hour.
  • Why sub-meters, not the bill. The saving is only about 2.5% of the building's use, which weather and occupancy can easily hide on the main bill. So the whole-building bill is a cross-check, not the proof.
  • Changes agreed in advance. If a tenant adds or removes a server room or changes office hours, the facility manager records the date and metered load. Then the baseline is adjusted by that load.
  • Who owns the evidence. The tower's facility manager collects and files it monthly, with a report by the 10th of the following month. Finance signs off the annual savings figure.

The M&V and upkeep cost of RM8,000 a year is already in the cash-flow model. The measured figures come from the building's own meters. And the demand evidence is the same monthly MD that our maximum-demand calculator works with.

The one-page memo

So now we can package the analysis so that a busy reader can decide from one page. For the office tower, the memo reads like this:

  • Executive summary. "We ask for RM130,000 to reschedule the chiller plant, fit VSDs to the two condenser water pumps and add BMS demand limiting. The measures are expected to save about RM158,100 in 2027 and repay their cost in under a year. Sub-metering during 2027 will prove them. We recommend proceeding."
  • Cash-flow picture. The Part 8 ten-year table, or its running-total chart.
  • Key indicators, all at the 8% nominal hurdle:

Indicator

Office tower measure set

Capex

RM130,000

Savings in 2027

RM158,065 (RM50,941 energy, RM107,124 demand)

NPV at 8% nominal, 10 years

about RM956,500

Simple / discounted payback

about 0.87 / 0.94 years

IRR

about 117%

Carbon avoided

112.5 t CO2e a year (carbon value shown separately, not in cash)

  • Sensitivity findings. "The result depends mainly on the demand saving. If M3 delivers nothing, the NPV is still about RM179,200. A 30% capex overrun lowers the NPV by about 4%."
  • Risks and mitigations. The demand limiting may not hold the peak (test it through a hot month, then check the MD monthly). The AFA and tariffs may change (bands shown). Tenants may change hours (baseline adjustment agreed in advance). Savings may fade (monthly M&V report).
  • Carbon impact and abatement cost. 112.5 t CO2e a year avoided at a negative cost per tonne.
  • M&V plan. Reporting period January to December 2027, with sub-metered evidence. The facility manager owns the evidence, and finance signs off.
  • The final investment call: proceed.

Back to the bill

So that's the whole chain, and it closes the question from Part 1. A bill arrived, someone had ideas to make it smaller, and we asked whether they were worth the money.

For the tower, it's a clear yes. RM130,000 buys about RM158,065 of savings in the first year, and the measures avoid 112.5 tonnes of CO2e a year. And we can now say how sure we are, and how we'll prove it.

That's also the end of the course. You can now take a saving from a TNB bill to a signed-off decision.

You value it at the marginal rate and prove it with an M&V plan. Then you model it year by year, test it, and present it on one page. For the underlying units, see kW versus kWh.

If you work on a site with boilers or steam, the optional side reading on thermal savings applies the same thinking to fuel.

From here, the natural next course is Cooling Fundamentals. That's where the same appraisal discipline meets the largest single load in most Malaysian buildings, the chiller plant.

Check your understanding

1. Why does the office tower memo rely on sub-meters rather than the TNB bill to prove the kWh savings?

Show the answer

The kWh saving is only about 2.5% of the building's annual use. Changes in weather and occupancy can easily be larger than that, so the main bill alone can't show whether the measures worked.

Sub-meters on the chiller plant and the condenser pump feeders measure the affected equipment directly, and the bill is only a cross-check. The demand saving is checked against the bill's MD each month.

2. The measures save about RM158,065 in 2027. Why does the payback use RM150,065?

Show the answer

Payback should use the net saving, which is the savings minus the running cost the project adds. Here that's the RM8,000 a year for M&V and upkeep, so 158,065 − 8,000 = RM150,065. The carbon value isn't added, because it isn't cash.

Recap

  • A credible energy efficiency business case is a chain. Value the savings at the marginal rate, compare life-cycle costs, and calculate NPV, payback and IRR.
  • Then test the inputs, estimate the cost per tonne, and state how the saving will be proved.
  • For the office tower measure set, RM130,000 of capex saves about RM158,065 in the first year and pays back in about 10 months.
  • It gives an NPV of about RM956,500 and an IRR of about 117% at an 8% nominal hurdle. It avoids 112.5 tonnes of CO2e a year at a negative cost.
  • The case depends mainly on the demand saving, so the M&V plan checks it every month.
