What Is a Sequence of Operation in a BMS?

A sequence of operation is the plain-English recipe telling a BMS what runs when, in what order. Learn how interlocks, staging and modes unify a plant.

Tan Kok XinTan Kok XinBuilding Automation & BMS Fundamentals
Illustration of chillers, pumps and fans in a ring with one pump highlighted, showing a start sequence

Part 6 of 16 in Cobler's Building Automation and BMS Fundamentals course. New here? See the course page.

Picture a kitchen assistant with every ingredient and every appliance, but no recipe. They don't know what goes in first, how long to wait, or when the dish is done. A building with good control loops but no plan is in the same spot.

Think back to 7:10 on level 12. AHU-12A's fan started first, and only then did the chilled water valve begin to open. Something decided that order.

In Part 4 and Part 5 we saw how one loop holds one value, such as the supply air at 14 °C. But when should AHU-12A start? What has to be true before its loops may run, and what happens when a part fails?

The building management system (BMS) gets all of that from a written plan called the sequence of operation.

When X, do Y

A sequence of operation is a list of plain-English rules of the form when X happens, do Y. HVAC (heating, ventilation and air conditioning) designers write it.

It says what runs, in what order, under what conditions and with what settings. Someone who doesn't write code should be able to read it and know how the equipment will behave.

A fragment for AHU-12A might read:

When level 12 east enters occupied mode, start the AHU-12A supply fan. When the fan status confirms that the fan is running, enable the chilled water valve loop to hold the supply air at its setpoint. If the fan status does not confirm running within one minute of the start command, raise an alarm and keep the chilled water valve closed.

That short paragraph holds four kinds of information:

  1. A trigger: the floor enters occupied mode.
  2. An order: fan first, then the valve loop.
  3. A condition that must be proven: the fan status must confirm that the fan is running.
  4. Numbers: the setpoint and the one-minute delay. A full sequence lists these in one place so they're easy to adjust later.

And the sequence comes before any controller code, as a specification. The building owner or their consulting engineer writes down how the building should behave. Then the automation contractor turns that into code in the DDC controllers from Part 3.

So here's a simple sequence for the whole of AHU-12A. It uses the seven points from Part 3:

  • the run command and the fan status
  • the supply and return air temperatures
  • the chilled water valve position
  • the supply fan speed
  • the filter differential pressure

It also needs one new point, a fire alarm signal. That's a digital input from the fire alarm panel, saying whether the alarm is active.

  1. Start. When the level 12 east schedule changes to occupied, the BMS sends the run command to the supply fan.
  2. Prove. The BMS waits for the fan status point to confirm that the fan is running.
  3. Run the loops. Once the fan is proven, the PI loop from Part 5 holds the supply air at 14 °C.
  4. Keep the valve closed when the fan is off. With no air moving across the coil, there's nothing to cool, so the valve stays shut.
  5. Watch the filter. If the filter differential pressure goes above its limit, raise a maintenance alarm.
  6. Stop. When the schedule changes to unoccupied, close the chilled water valve and stop the fan.

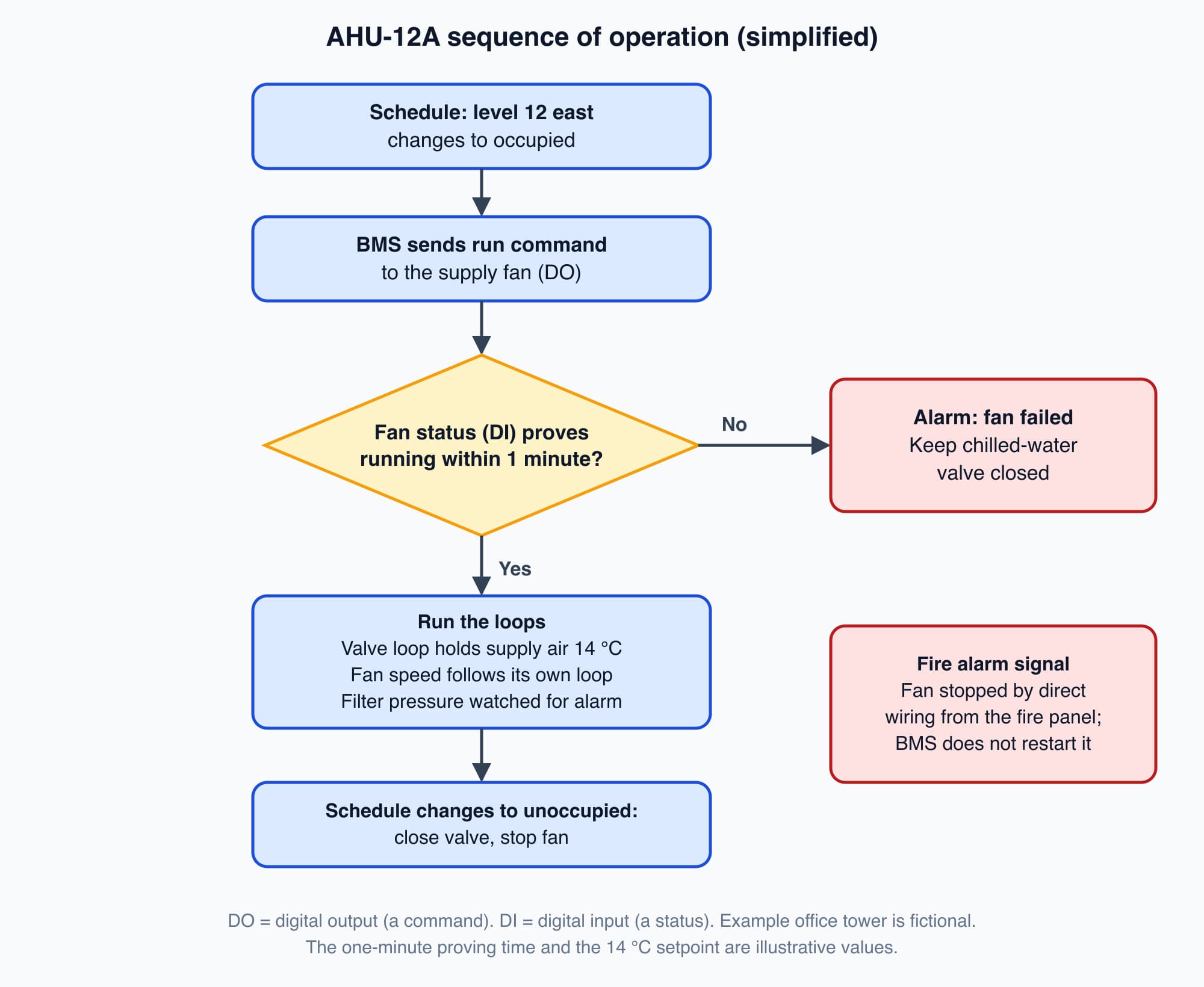

Flow chart of the AHU-12A sequence of operation: occupied schedule, run command, wait for fan status, then run the supply air loop, or raise an alarm and keep the valve closed if the fan is not proven

AHU-12A's sequence as a flow chart. The valve loop only runs once the fan status proves the fan is running.

A few notes on those steps:

  • Part 7 explains how the start time is chosen.
  • The fan speed follows its own loop, which Part 13 explains.
  • The filter differential pressure is the pressure drop across the filter, which rises as the filter clogs.

Interlocks

Now look at that "Prove" step again. Why wait for the fan status, when the BMS has just told the fan to run? This is the most important habit in any sequence.

An interlock is a rule that allows or blocks an action depending on the proven state of other equipment. It doesn't trust that a command was obeyed, so it waits for evidence.

The run command is what the BMS asks for. The status is a separate signal that comes back from the equipment, and what it proves depends on where it comes from:

  • A run contact in the fan's drive or starter only proves that the drive or starter has switched on. The motor could be turning with a broken belt and moving no air, and this contact would still say "running".
  • A differential pressure switch across the fan closes only when the fan is building up air pressure, so it proves that air is moving.
  • A current switch on the motor cable is set to see the motor's normal working current. A motor turning a broken belt draws much less, so the switch drops out.

So for AHU-12A, the fan status should come from a differential pressure switch or a current switch. That way it proves airflow, not just a closed starter.

Then if the command says "run" and the status still says "stopped" after the set delay, something's wrong. The drive may have tripped, the belt may have broken, or someone may have switched the fan off at the panel.

A good sequence never treats "commanded" as "running". Part 15 checks where the status signal really comes from before the building is handed over.

The chiller plant has the classic interlock, and it's worth seeing why. A chiller takes heat out of the chilled water that cools the building.

It passes that heat into a second water loop, the condenser water loop. The condenser water carries it up to the cooling towers on the roof, which release it to the outside air. For now we only need that direction of the heat, from the building, through the chiller, to the tower.

Worth knowing: the Cooling Fundamentals course explains these loops in how a chilled water system works and how a cooling tower works.

So what happens if a chiller starts before the condenser side is ready? The moment it starts, it pushes heat into the condenser water.

If that water isn't already flowing, and the tower isn't ready to release heat, the condenser side's pressure and temperature rise within seconds. The chiller then trips on its high-pressure safety, or, if a safety fails, it can be damaged.

So the sequence enforces an order:

  1. Start the condenser water pump and prove that water is flowing. A flow switch or a pressure reading confirms it. A running pump motor doesn't prove that water is moving.
  2. Enable the cooling tower fan so the tower can release heat. In practice the tower fan often starts or speeds up as the condenser water warms.
  3. Only then allow the chiller to start.
Worth knowing: a chiller also needs proven flow in its chilled water loop before it starts. We're focusing on the condenser side here because it shows the order most clearly.

On shutdown, the order reverses. When the chiller stops, the condenser water pump and tower keep running for a set time. That's because the chiller still holds hot refrigerant that needs to lose its heat. Then the sequence stops them.

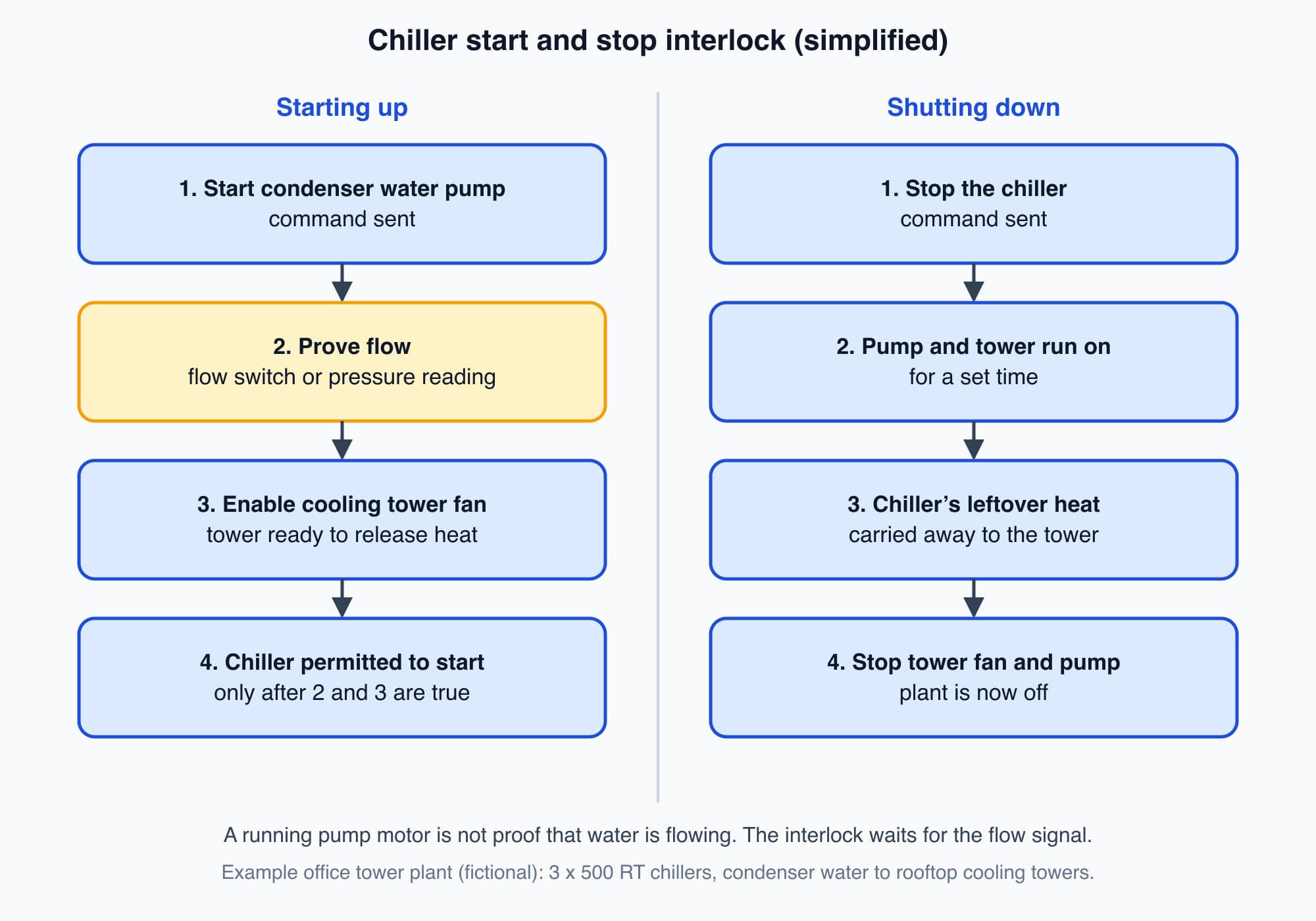

Chiller start and stop interlock: start the condenser water pump and prove flow, enable the tower fan, then permit the chiller, and on shutdown stop the chiller first and run the pump on for a set time

The chiller is only allowed to start after the condenser water flow is proven. On shutdown, the pump and tower run on for a set time.

Some interlocks live outside the BMS altogether. In most buildings, the fire alarm panel is wired directly to trip fans such as AHU-12A. So the trip works even if the BMS is switched off.

The BMS reads the fire alarm signal so it can show and record what happened. That also stops its own sequence trying to restart the fan.

When something fails

That leads to the third question. What should a sequence say about failures? Every sequence should spell out what happens when a part fails, because that's when people most need predictable behaviour. For AHU-12A, it might say:

  • The fan doesn't prove. Raise an alarm and keep the chilled water valve closed.
  • The supply air sensor fails. If the reading disappears or goes outside a believable range, raise an alarm. Hold the valve at a fixed position written in the sequence, so the floor gets some cooling until the sensor is repaired.
  • The supply air stays too warm. If it stays well above 14 °C for a set time even with the valve fully open, raise a "failure to achieve setpoint" alarm. The loop is doing all it can, so the cause is elsewhere, perhaps in the chilled water supply. Part 8 shows how to read this on a trend.
  • The network fails. AHU-12A's controller keeps running its own sequence with its own schedule and setpoints, as Part 3 explained. The operator loses the view, but the floor stays under control.
  • The power fails and returns. The controller restarts the fan on its own after a set delay. The delay stops dozens of AHUs all starting at the same moment, and Part 14 explains why that matters for the electricity bill.
  • The fire alarm operates. The fan stops through the direct wiring, and the sequence doesn't restart it until the fire alarm is reset.

Modes

Now, a building behaves differently at 3am than at midday. A floor at 26 °C needs action when people are working, but it may be fine when the floor is empty.

A sequence handles this with modes, which are named states that each have their own rules. The main ones for AHU-12A are:

  • Occupied: the floor is in use, and the loops hold their normal setpoints.
  • Unoccupied: the floor is empty, and the cooling is relaxed or off.
  • Start-up (pre-cooling): the time before people arrive, when the plant brings the floor to comfort. That's what was happening at 7:10.
  • Fire: the fan is stopped and stays stopped until the fire alarm is reset.

With modes, the sequence states the rules once for each mode, and the schedule switches between them.

Worth knowing: in the office tower, the BMS also runs the lighting schedules and the car park ventilation fans. Their sequences are usually simpler, often a schedule plus one or two conditions. Fire systems have their own control panels and rules, and the BMS mostly monitors them.

Staging

So far we've looked at one AHU. But the plant behind it has its own sequence, and its biggest job is staging.

A building's cooling load changes through the day. A Malaysian office is nearly empty at 7am, full and sunlit by 2pm, and emptying by 7pm.

One chiller big enough for the 2pm peak would spend most of the day at a small fraction of its capacity. And chillers, like most machines, run less efficiently when they're badly under-loaded.

So larger plants use staging. They have several machines, brought on one at a time as the load rises and turned off as it falls.

The office tower has three 500 RT chillers, with two on duty and one on standby. RT means refrigeration tons, a measure of cooling capacity.

In outline, the sequence starts the next chiller when the running ones can't hold the chilled water setpoint for a set time. The new chiller gets its own pump and tower interlock. The sequence stops one when they're lightly loaded for a set time.

Staging also gives resilience, because if one chiller trips, the standby can start. Part 12 covers chiller staging in detail.

Numbers to tune

Look back at the sequence and you'll notice it's full of numbers. Those are meant to be adjusted, because no design is perfect on paper and every building behaves a little differently once it's built:

  • Setpoints are the targets, such as 14 °C supply air or a chilled water supply temperature.
  • Time delays are the waits written into the rules. Examples are how long a condition must last before staging up, and how long the condenser pump runs on after a chiller stops. Another is how long a value stays out of range before an alarm.
  • Deadbands are the gaps between an "on" point and an "off" point, used for switching, staging and alarms, as Part 4 explained. A stage-up threshold and a lower stage-down threshold stop a chiller being switched on and off over and over.
  • Tuning settings are the gain and integral settings of each modulating loop, from Part 5.

Delays stop the plant reacting to every brief wobble. Stage up too eagerly and you run machines you didn't need, but stage up too slowly and the building overheats before help arrives.

Setting all these numbers well is most of what commissioning and later optimisation involve. Commissioning means proving the system works before handover.

Timing also affects the electricity bill. The office tower's Medium Voltage (MV) General tariff has capacity and network charges on its maximum demand, the month's highest half hour. On a tariff like that, the sequence can avoid starting several large machines at once, and Part 14 explains how.

Published savings from better sequences vary widely and depend on the site, so treat any single percentage with caution.

The contract and the test list

So who holds the building to all this? In practice, the sequence of operation is the contract between the building owner and the automation contractor.

The contractor is paid to make the building behave as the sequence describes. If every mode, interlock, failure response, setpoint and delay is written down, both sides know when the job is finished.

Now imagine the sequence only says "the chillers shall stage as required". There's no agreed meaning for "as required", so every later disagreement has nothing to settle it.

Writing and building a clear sequence is a core part of building automation work.

A clear sequence also gives us the list of things to test. Each rule becomes a check that someone can witness before handover. For AHU-12A, the list starts like this:

The sequence says

How to check it

The fan starts when the floor becomes occupied

Change the schedule and watch the run command and fan status change

The valve loop holds supply air at 14 °C

Change the setpoint and check on the trend that the loop settles (Part 5)

If the fan does not prove, raise an alarm and keep the valve closed

Stop the fan at its drive while it is commanded on. The alarm should appear and the valve should stay closed

The fan status proves airflow, not just a closed starter

Check that the status comes from the differential pressure switch or current switch, not from a contact in the drive or starter

If the supply air sensor fails, raise an alarm and hold the valve at its fixed position

Disconnect the sensor, then check the alarm and the valve position

The fire alarm signal stops the fan

Simulate the signal together with the fire alarm contractor

After a power failure, the fan restarts on its own after a delay

Switch the controller's power off and on and time the restart

Part 15 turns this list into a full commissioning and handover exercise. And the sequence outlives the project.

Years later, when the equipment does something surprising, everyone goes back to it to ask one question. Is the equipment doing the wrong thing, or the thing it was told to do? So keep the final version with the building's records.

The schedule

So now AHU-12A knows its order, its proofs and what to do when things fail. But its sequence still starts with "when the schedule changes to occupied", and we haven't said where that schedule comes from.

So how far can the cooling relax when the floor is empty? And how does the BMS decide that 7:10 is the right moment to start? That's Part 7: BMS Scheduling and Optimum Start.

Check your understanding

1. The BMS sends AHU-12A's run command, but one minute later the fan status still says "stopped". What should the sequence do, and why not just trust the command?

Show the answer

It should raise an alarm and keep the chilled water valve closed. A command is only a request, and the status is the evidence.

That holds as long as the status comes from a differential pressure switch or current switch that sees the fan working. A drive trip, a broken belt or a local switch can all stop the airflow even though the BMS asked the fan to run.

A contact in the drive or starter wouldn't catch the broken belt, because it only proves the starter closed.

2. Why must the condenser water pump be proven before a chiller starts, and why does it keep running after the chiller stops?

Show the answer

A running chiller pushes heat into the condenser water straight away. Without proven flow, the condenser side's pressure and temperature rise within seconds, and the chiller trips or is damaged.

After the chiller stops, it still holds hot refrigerant, so the pump and tower run on for a set time to carry that heat away.

Recap

  • A sequence of operation is the written "when X, do Y" plan that turns separate loops into equipment that works as one system.
  • It sets the order of starting and stopping, and its interlocks wait for proven status instead of trusting a command.
  • It says what happens when a fan, sensor, network or power supply fails.
  • It stages chillers on and off, switches between modes, and lists the setpoints, delays, deadbands and tuning settings that commissioning adjusts.
  • Written clearly, it's the contract between owner and contractor, and the start of the commissioning test list.
