The Malaysia Electricity Grid

Follow the Malaysia electricity grid from a power station's step-up transformer, down the 500, 275, 132, 33 and 11 kV ladder to 400/230 V. See why each step exists, how 50 Hz keeps supply and demand balanced every second, and where an office tower's 11 kV intake joins it.

Tan Kok XinTan Kok XinElectricity Fundamentals
Transmission pylons carrying a glowing conductor from a power station past palm trees to the Kuala Lumpur skyline

Part 13 of 24 in Cobler's Electricity Fundamentals course. New here? Start with the course map.

The office tower from Part 12 draws about 1,740 kVA at its peak. Every kVA of it was made on the Malaysia electricity grid less than a second earlier.

So what does that look like in practice? Let's pick one moment, at 3:30 on a hot weekday afternoon, when a second chiller starts in the tower's plant room.

The building's demand climbs by a few hundred kilowatts, and nobody phones a power station about it. Yet within seconds, generators somewhere on the grid are taking in a little more steam, gas or water to cover it.

We've already built each machine on the way: the generator (Part 7), the transformer (Part 9) and three-phase supply (Part 10). So how are they joined up, between one power station and one building?

Voltage levels on the Malaysia electricity grid

Well, let's follow the electricity out of a power station and count the transformers on the way. The first thing we notice is that it keeps changing voltage.

It gets stepped up once beside the generator, then down at three or four substations. Each step is a transformer from Part 9, doing the same trade of voltage for current.

The generator makes three-phase alternating current (AC) at 50 Hz. A step-up transformer beside it then raises the voltage to 132 kV, 275 kV or 500 kV for the National Grid. Those 500 kV lines are the highest level in Peninsular Malaysia (National Grid, Malaysia).

Then substations step it down, from 500 kV or 275 kV to 132 kV, then to 33 kV and 11 kV. A final distribution transformer, in a substation near the building or on a pole, brings it to 400/230 V.

Each transformer's windings set its ratio, the way we saw in Part 9. So an 11 kV to 400 V unit divides the voltage by 27.5 and multiplies the current by the same factor.

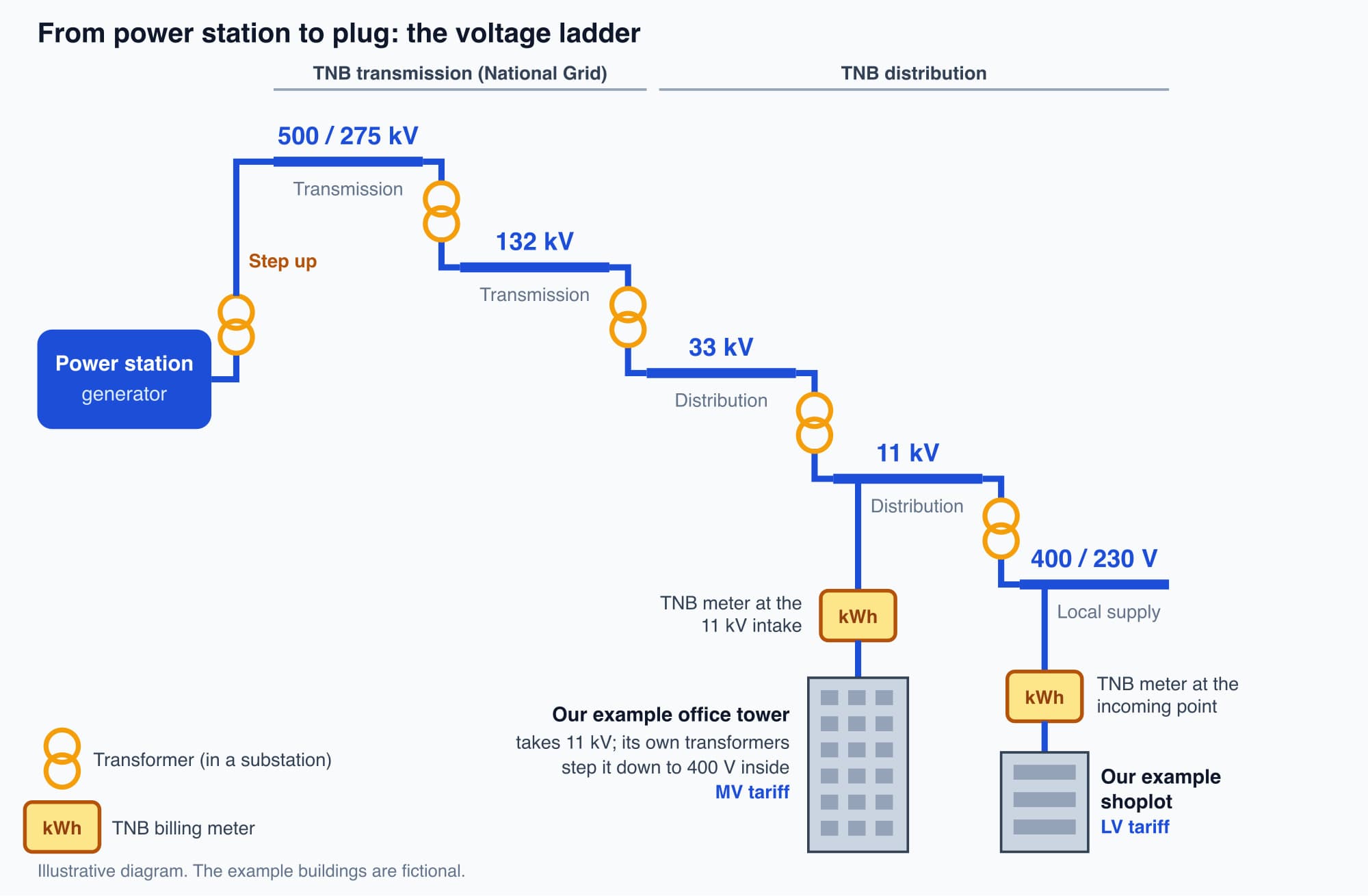

The voltage ladder from a 500 kV or 275 kV transmission line down through 132 kV, 33 kV and 11 kV to 400/230 V, showing where our example office tower and example shoplot connect and where each TNB meter sits

The voltage steps down at each substation, and each building connects at the level that suits its size.

The office tower takes 11 kV and owns its two 1,500 kVA transformers. So with the step-up at the power station, the electricity reaching a socket in the tower has passed through four or five transformers.

Now you'd probably expect all those steps to lose a lot of energy, and to be honest, I did too. But the transmission losses of TNB (Tenaga Nasional Berhad), the utility, were only about 1.47% in 2020 and 1.6% in 2021 (Southeast Asia Infrastructure).

Far more is lost at the power station itself, where a coal plant turns well over half of its fuel's energy into waste heat.

Current at each voltage

So why so many levels? Well, each voltage is a trade-off. A higher voltage carries the same power with less current, and less current means far less heat lost in the wires.

But a lower voltage is cheaper to insulate, and safe enough to bring into a room. So the grid uses its highest voltages for the biggest, longest flows, and steps down as the flows get smaller and closer to people.

That heat is Part 3's \(I^2 R\), and Part 8 showed how fast it falls as the voltage rises. So let's see what that means for one building. Using the three-phase rule, here's the current the tower's 1,740 kVA needs at each step of the ladder:

$$I = \frac{S}{\sqrt{3} \times V}$$

Voltage

Where you find it

Current for the tower's 1,740 kVA

132 kV

Grid lines into a town's main substation

about 7.6 A

33 kV

Lines across a district

about 30 A

11 kV

Cables along the street

about 91 A

400 V

Inside the building

about 2,510 A

So the same power at 400 V needs about 27 times the current it needs at 11 kV. And since heat goes with current squared, a cable of the same size would lose about 750 times as much heat.

That's why the tower is fed at 11 kV and only drops to 400 V in its own basement, a few metres from the switchboard.

At national scale the numbers get even bigger. A power station sending 1,000 MW at 500 kV needs about 1,150 A on each phase (ignoring power factor). The same 1,000 MW at 11 kV would need about 52,000 A, and no practical line could carry that.

So why not just run 132 kV to every building? Well, because insulation gets expensive fast. At 400 V, a millimetre or two of PVC plastic around the copper is enough (Part 1).

But at 275 kV the air itself is the insulation, so bare wires hang from long strings of insulators on tall steel towers, metres apart. Switchgear and safety clearances grow with voltage too. So each step on the ladder is the cheapest compromise for its distance and its power.

Balancing the grid

Now let's go back to that chiller starting at 3:30. The grid stores almost nothing, and a power station may be hundreds of kilometres away. So how does it even know that the tower's chiller has started?

Well, nobody tells it. The grid feels the start through the wires, and what it feels is Part 7's push-back.

Every large generator on the grid spins in step with every other one. When the tower's chiller starts, it draws more current, and that current pushes back a little harder on every rotor on the grid (Lenz's law).

Until more fuel arrives, the rotors pay for the extra power out of their own spin. So they slow very slightly, and the frequency dips below 50 Hz. Those heavy spinning rotors are the grid's only instant store of energy.

The governors on the generators work kind of like a car's cruise control on a hill. When the speed sags, they open the throttle, which here means the steam, gas or water valves. They react by themselves, but someone still has to decide which power stations make more.

So who does that? Sabah and Sarawak run separate grids, so let's take Peninsular Malaysia, where the work splits like this:

  • TNB owns almost all of the transmission and distribution network.
  • The Single Buyer, a ring-fenced unit within TNB, buys the electricity from the power stations (Single Buyer).
  • The Grid System Operator (GSO), also ring-fenced within TNB, runs the grid in real time (GSO). It decides second by second which stations raise or lower their output.

The GSO reads the balance from the frequency, so we can read the frequency like a gauge too:

  • Steady at 50 Hz: supply matches demand.
  • Dipping below 50 Hz: demand is ahead. Governors open their valves, and the GSO then calls on more power stations.
  • Creeping above 50 Hz: supply is ahead, and output is trimmed.

The Grid Code for Peninsular Malaysia requires the frequency to stay between 49.5 and 50.5 Hz, outside exceptional events (Energy Commission Grid Code, section CC.6.2.3).

But when a large part of the grid trips at once, the frequency can fall faster than the governors can respond. If supply can't rise that fast, what's left?

Well, what if demand fell instead? That's the job of automatic relays, which cut supply to whole areas on purpose to save the rest.

On 27 July 2022, a trip at the 275 kV North Yong Peng main intake substation in Johor caused a frequency drop across the grid. The automatic load-shedding scheme cut supply to several areas, and restoration was completed in 2 hours and 21 minutes (Bernama).

Worth knowing: what happens when the balance is lost completely is the side reading Why Blackouts Happen.

Building connections and demand charges

So where does a building actually join all this? Well, it depends on how big it is:

  • A house usually takes one 230 V phase.
  • A row of shoplots takes 400/230 V three-phase from a TNB substation down the street.
  • Very large plants connect at 33 kV or even 132 kV.
  • In between, larger buildings like the tower take 11 kV, or sometimes 6.6 kV or 33 kV, and own their transformers.

These medium-voltage (MV) customers pay a monthly charge on every kW of their maximum demand. But why the peak, and not the average?

The physics is Part 3 again. A cable or transformer overheats on the current it carries at its worst moment, whatever its monthly average is. So TNB has to size every step of the ladder for the building's maximum demand (Part 5), its highest 30-minute average of the month.

That's what the demand charge we priced in Part 5 pays for. The tower's RM142,800 a month keeps every transformer and cable between the power station and its intake ready for that one half-hour.

A poor power factor (Part 12) pushes extra current through that same chain, which is why TNB adds its surcharge. The bill side is covered in Maximum Demand: Why One Bad Half-Hour Costs So Much.

The office tower's 11 kV intake

So let's walk into the tower's intake room (details illustrative). This is the room where TNB's supply arrives and the building's own system starts, and there are four things to see:

  1. TNB's ring main unit. TNB's 11 kV cables arrive underground in a loop through several substations. If one cable fails, supply can still reach the tower from the other direction.
  2. TNB's meter. It can't connect to 11 kV directly, so it reads through instrument transformers. These scale the voltage down to 110 V and the current down to a few amps. This is where TNB records the tower's kWh, its reactive energy and its maximum demand. Part 19 builds the current transformer inside.
  3. The building's 11 kV breakers, one guarding each transformer feeder.
  4. The two 1,500 kVA transformers, each stepping 11 kV down to 400/230 V for the main switchboard.

Now here's something kind of surprising. At the 1,600 kW peak, the whole tower draws only about 91 A on each 11 kV phase.

That's about the current of four or five fan motors like the one in the level-3 air handling unit, for the entire building. That fan motor from Part 11 draws 20.4 A at 400 V. On the 400 V side, each transformer carries about 1,250 A, the figure from Part 12.

So where the tower joins the ladder decided three things:

  • where TNB's meter sits
  • who owns and maintains the transformers
  • which tariff it pays
Worth knowing: Inside the Consumer Substation, in the Building Electrical course, walks the room in detail.

Fault current

Now the same ladder that delivers 1,600 kW so easily can also drive a huge current into a fault. Let's work it out for one of the tower's 1,500 kVA transformers.

Its full-load current is 1,500,000 ÷ (1.732 × 400) ≈ 2,165 A. For a transformer this size, the international standard gives 6% as the usual minimum impedance (IEC 60076-5, Table 1). That means only 6% of its rated voltage would push full-load current through a dead short.

So a short circuit at its terminals could draw about 2,165 ÷ 0.06 ≈ 36,000 A (illustrative, because the cables and the network upstream reduce it). A short circuit is a path with almost no resistance (Part 4), and a current like that would melt copper in moments.

And with this much energy on the move, faults are going to happen. Over the years insulation ages and water gets in, and every so often a drill finds a cable. So how do we keep people and equipment safe when that happens? Part 14 builds the answer.
